Delivering Ship Stores at Saudi Ports

Ordering stores is the easy part. What decides whether they reach the vessel is the agent, the gate, and a cut-off that is always earlier than the sailing time.

Plenty of directories will tell you which companies supply ship stores in Saudi Arabia. Almost nothing explains how a delivery physically gets to a vessel — and that, not the order, is where things go wrong.

If you are a purchaser, superintendent or agent working a Saudi call, this is the sequence that decides whether the stores are on board before she sails.

The agent nominates the chandler, not the ship

For a vessel calling at a Saudi port, the local agent is the party arranging port formalities, and deliveries reach the vessel through that arrangement. A chandler cannot simply drive to a berth because an order was placed by a purchasing office overseas.

The practical consequence: an order placed directly with a supplier still has to be tied into the agent's arrangements, and if the agent has not been told, the delivery has no route in. Where a management company has a preferred supplier, the agent should be told at nomination — not on the morning of the call.

Stores cut-off is earlier than ETD, and it is not one deadline

The sailing time is the least useful date in the chain. What matters is the cut-off, and there are usually several stacked on top of each other:

  • The agent's cut-off for advising deliveries and raising gate passes.
  • The port's gate hours, which are not necessarily twenty-four hours for goods vehicles.
  • Customs clearance where the goods are imported rather than locally sourced — this is the one that turns days into weeks if the paperwork is wrong.
  • The vessel's own working hours and whether the crew can receive and stow at that time. A delivery landed on deck at 03:00 with nobody to take it is not a completed delivery.

Work backwards from the earliest of those, not from the ETD. An order confirmed the day before a night sailing has almost certainly already missed something.

The Eastern Province ports are not interchangeable

People say "Dammam or Jubail" as though it were one logistics problem. It is not.

King Abdulaziz Port, Dammam is the main commercial port on the Gulf coast and handles the widest mix of cargo and vessel types. It is generally the most straightforward for conventional stores delivery.

Jubail has two quite different facilities. Jubail Commercial Port handles general commercial traffic. King Fahd Industrial Port serves the industrial city and its petrochemical export terminals — a different environment with different access control, and one where a delivery vehicle and driver need the right clearance rather than simply the right paperwork.

Ras Tanura is a terminal environment rather than a commercial port, and access is controlled accordingly. Deliveries there depend entirely on the arrangements the agent and terminal have in place, and no supplier can promise access on their own account.

The mistake is treating a quotation for one as a quotation for another. Access conditions, notice period and vehicle requirements differ, and so does the realistic lead time.

Alongside, or out to anchorage

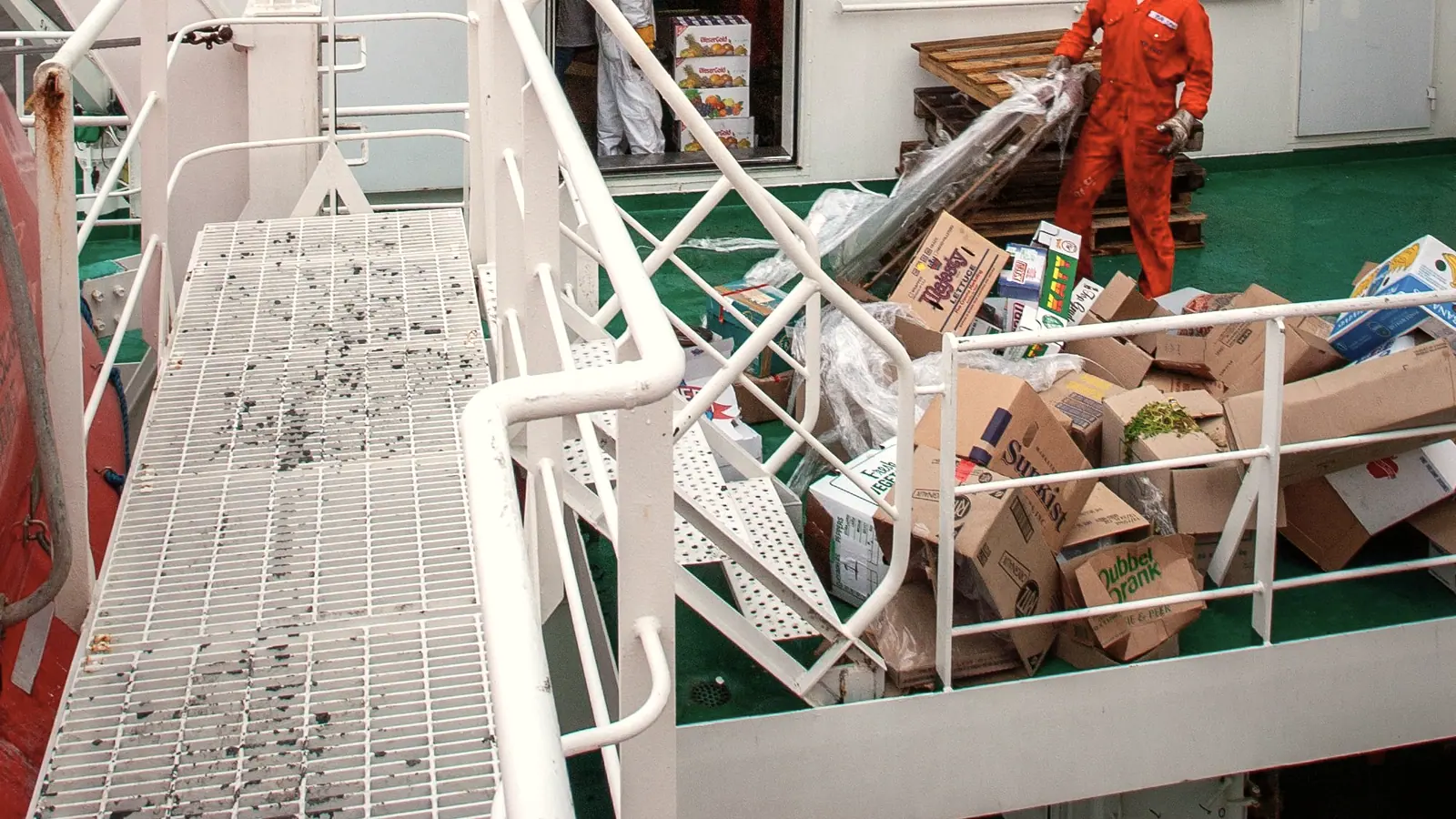

If the vessel is at a berth, stores go alongside by road and up by the ship's crane or gangway. That is the cheap, simple case.

If she is at anchorage, stores go by launch or supply boat. That is a different job entirely: it needs a boat booked, a weather window, a longer notice period, and it costs materially more. It also has a hard limit on what can be transferred safely — size, weight and how the item can be slung.

The decision is not always known when the order is placed, which is why a good enquiry says "berth or anchorage, to be confirmed" rather than assuming alongside. A supplier who has quoted alongside and is asked for a launch delivery on the day will either be late or expensive.

The berth change nobody plans for

Berths move. A vessel shifted to a different berth, or to anchorage, resets gate passes, vehicle routing and sometimes the delivery method altogether. If the stores are already at the gate for the original berth, they may not simply be redirected.

What reduces the damage: keeping the delivery flexible until it is confirmed, having the agent advise changes immediately rather than at the next working day, and not scheduling a delivery so tight against departure that a shift leaves no room.

What a deliverable order looks like

An enquiry that can actually be executed contains:

  • Vessel name and IMO number. Names repeat; IMO numbers do not.
  • Port, and berth or anchorage if known.
  • ETA and ETD, and the agent's name and contact.
  • The requisition itself, ideally as a spreadsheet or a standard catalogue-coded list rather than free text.
  • Which items are statutory — anything where an approval or certificate is required, so it is quoted to the right specification rather than to the cheapest equivalent.
  • Who receives and signs, and whether the crew can take delivery outside working hours.

On statutory items in particular, say so in the enquiry. Life-saving and firefighting equipment carries approval requirements, and an item that is functionally similar but not approved is not a saving — it is a deficiency at the next inspection.

The honest summary

Most late stores are not late because a supplier was slow. They are late because the order arrived after a cut-off nobody had stated, the agent was not told, or the vessel moved. All three are avoidable with a day's notice and the six lines above.

We quote requisitions line by line, mark anything we cannot offer rather than dropping it, and work through the vessel's agent for delivery. See Deck & Engine Stores and Marine & Port Supply, or the pages for Dammam, Jubail and Ras Tanura. Send the requisition through our contact form with the vessel name, IMO and dates.
